Shift schedule

A shift schedule is the plan that says which employee works which shift, on which days and at what times, so that every hour the business is open has the people it needs.

Written by: Rinaily BonifacioUpdated on:

A shift schedule tells everyone who works when. For the planner it is also the place where opening hours, wage costs, holiday requests and the rest rules all have to fit into one week.

What is a shift schedule?

A shift schedule is the plan that assigns named employees to shifts, with the date, the start and finish time and usually the role or department for each one. It turns the hours a business needs covered into a list of people who will be there.

Three neighbouring terms get mixed up with it. A work schedule is the days and hours one employee is expected to work, which can be a plain Monday to Friday, 09:00-17:00 week with no shifts at all. A shift pattern is the repeating cycle of shifts and days off, such as four on, four off, before any names are attached. And a rota or roster is mostly the same document as a shift schedule under another name: UK workplaces say rota, hospitals and the hospitality trade often say roster, and software tends to say schedule.

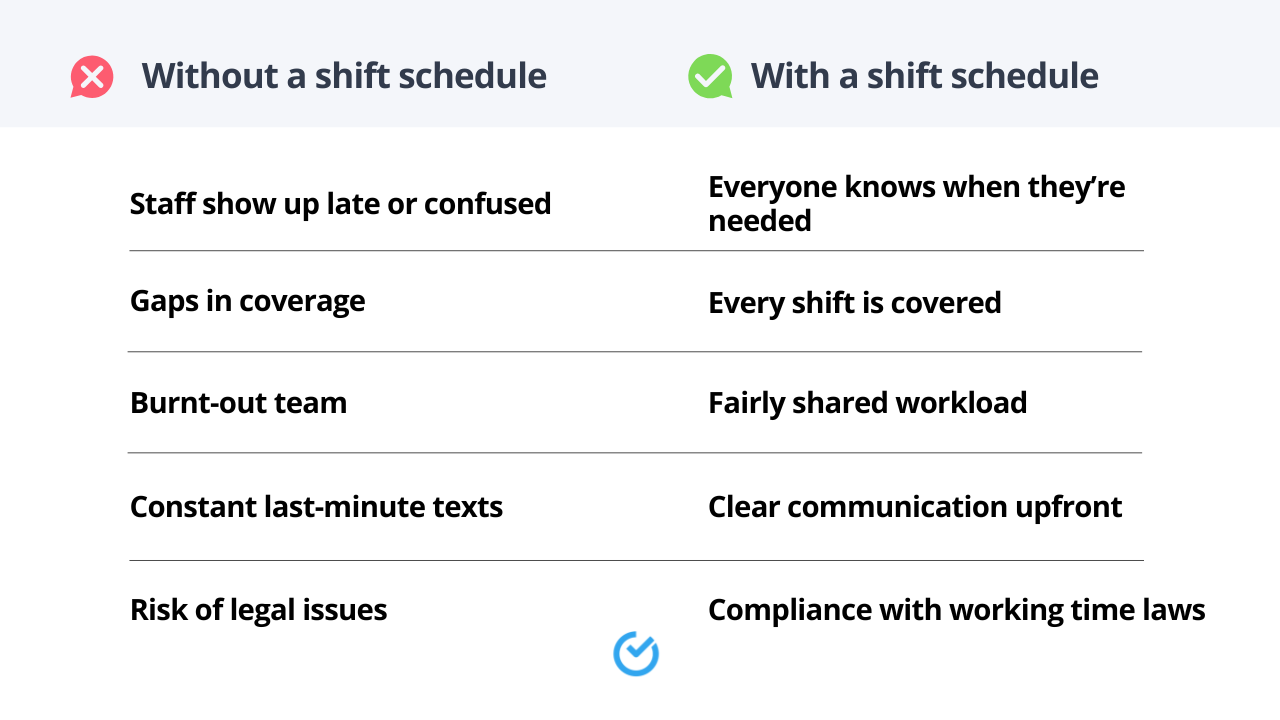

How shift schedules help your business - By Shiftbase

What a shift schedule should show

A schedule is read by someone checking their week on a phone at the bus stop, so it only needs a few things, and each one has to be right:

  • the date and the day of the week

  • the start and finish time of each shift, in 24-hour time

  • the employee on it, or a marker that the shift is still open

  • the role or department, where people do different work on the same shift

  • the planned break, if your team takes breaks at set times

  • anything unusual, such as a delivery, a stocktake or a training session

What it should not need is a separate message to explain it. If staff regularly ask what a code on the schedule means, the code is the problem.

Types of shift schedule

Most shift schedules are built on one of a handful of patterns. The choice depends on how many hours a day you are open, whether you run nights, and how long a shift your work allows.

Type

How it runs

Where you see it

Fixed

The same shift on the same days every week

Shops and cafés with stable opening hours

Rotating

Staff move between early, late and night shifts on a cycle

Warehouses, care homes, contact centres

Split

One working day in two parts with a long unpaid gap

Restaurants with a lunch and a dinner service

Staggered

Start times spread out so cover builds up and tails off

Retail, logistics, call centres

On-call

Someone is available to come in or respond outside normal shifts

Maintenance, IT support, healthcare

2-2-3 / Pitman

12-hour shifts over a 14-day cycle of 2 on, 2 off, 3 on, 2 off, 2 on, 3 off

24/7 sites with four crews

DuPont

Four crews on 12-hour days and nights over 28 days, with seven days off once per cycle

Plants, utilities

Continental

Fast forward rotation through 8-hour mornings, afternoons and nights

Manufacturing, 24/7 operations

4 on, 4 off

Four 12-hour shifts, then four days off

Security, transport, care

A rotating shift shares the unpopular hours across the team, a split shift follows the two peaks of a restaurant day, and an on-call schedule covers the hours nobody is rostered for. The 12-hour patterns are explained cycle by cycle under Pitman, DuPont and continental, and what round-the-clock cover takes in crews and hours is under 24-hour shift schedule.

How to make a shift schedule: a worked example

Take a convenience store that opens from 07:00 to 22:00, seven days a week. The owner wants two people on the floor at all times and a third during the lunch peak (11:00-14:00) and the after-work peak (16:00-19:00).

1. Turn opening hours into shifts. Two people for fifteen hours is 30 staffed hours a day, and the peaks add six more. The owner settles on three shift types:

  • Early, 06:45-14:45, two people, with a quarter of an hour to open up

  • Mid, 11:00-19:00, one person, who covers both peaks

  • Late, 14:15-22:15, two people, with a quarter of an hour to close

The half hour from 14:15 to 14:45 is the handover, when the early and late teams overlap. That gives 5 shifts of 8 hours, or 40 scheduled hours a day and 280 a week.

2. Place the breaks against cover. Each of those shifts is longer than six hours, so every worker is entitled to an uninterrupted rest break of at least 20 minutes (Working Time Regulations 1998, regulation 12). With two people on the floor, a break before 11:00 leaves one person alone in the shop. The earlies therefore take theirs between 11:00 and 14:00, while the mid shift is in, and the lates take theirs between 16:00 and 19:00. The peaks are when the third person is there, so that is when breaks cost the least cover.

3. Work out how many people you need. 280 hours a week, filled by staff on contracts of around 32 hours, is just under nine people. But almost every worker is entitled to 5.6 weeks' paid holiday a year (GOV.UK), so each person is available for about 46.4 weeks out of 52. Spread over the year, the 280 hours need around 314 contracted hours, which is ten people at 32 hours. Sickness comes on top, which is why it helps to have one or two people on smaller contracts who are happy to pick up extra shifts.

4. Put names on the shifts. Start with what you can't move: fixed days off, people who can only work evenings, the two staff trained to open the safe. Then fill the rest, and give each person two days off together where you can.

5. Check rest before you publish. One combination keeps turning up in this kind of schedule: a late on Friday until 22:15, then an early on Saturday from 06:45. That leaves 8.5 hours between shifts, and an adult worker is entitled to 11 consecutive hours of rest in each 24-hour period (regulation 10). The regulations make an exception for shift workers changing shift (regulation 22(1)(a)), but then the employer must wherever possible give equivalent compensatory rest (regulation 24), so the easier fix is not to plan it at all. This late-then-early pairing has its own name, the clopening. The other checks are the weekly rest of at least 24 uninterrupted hours in each seven days, or 48 hours in each fourteen (regulation 11), and an average of no more than 48 hours a week over 17 weeks unless the worker has opted out in writing (regulation 4). Workers under 18 are entitled to 12 hours' daily rest and a 30-minute break once they work more than four and a half hours (regulations 10(2) and 12(4)), which matters in a shop with Saturday staff.

6. Publish it early and keep it current. Two weeks ahead gives people time to arrange childcare and second jobs, and their contract may set a notice period of its own. After that, every change goes into the schedule itself, not into a group chat, so that the version on the wall and the version on the phone stay the same.

If you would rather start from a spreadsheet, the shift planning Excel template has the weekly grid with hours per employee already set up.

Designing a schedule people can keep working

The Health and Safety Executive's guidance on shift work, Managing shiftwork (HSG256), sets out good practice for the design of a shift schedule. It is guidance, not law, written to reduce the risks of shift work. The points that change a rota most:

  • Rotate forwards, from early to late to night, rather than backwards.

  • Rotate either quickly, every 2-3 days, or slowly, every 3-4 weeks. Weekly and fortnightly rotation is the one to avoid.

  • Avoid starts before 07:00 unless the business needs them. The store above does, because it opens at 07:00, and that is the kind of reason HSE asks for.

  • Keep shifts to 12 hours at most, overtime included, and to 8 hours for night work or work that is demanding, monotonous or safety-critical.

  • Limit long shifts, night shifts and early starts to 2-3 in a row, and working days in general to 5-7 in a row.

  • When someone moves between days and nights, give them at least two nights' full sleep in between.

  • Build regular free weekends into the cycle.

For night workers there is also a legal limit: normal hours may not exceed an average of 8 hours in each 24 over the reference period, usually 17 weeks (regulation 6).

Making shift schedules in Shiftbase

In Shiftbase you make the schedule automatically or yourself: auto-scheduling fills the required shifts based on availability, contract hours, maximum weekly hours and skills, and any shift can still be changed by hand. While you plan, Shiftbase flags a shift that overlaps approved leave or another shift, or that takes someone past their contract hours. Holiday and sickness come in through absence management, so they show on the schedule before you fill the week. Employees see their shifts in the app, along with open shifts they can pick up. Worked hours are recorded with time tracking, on the phone or through the Kiosk in a browser on a PC or tablet, so planned and worked hours can be compared afterwards. Shiftbase does not check a schedule against the Working Time Regulations: the rest and weekly-hours checks above stay with the planner.

You can try Shiftbase free for 14 days.

Frequently asked questions

A shift schedule and a rota are usually the same document: the plan that shows which employee works which shift on which day. Rota is the everyday word in UK workplaces, while shift schedule is more common in software and in American English. A shift pattern is different, because it describes the repeating cycle of shifts and days off without names attached.

A shift schedule is best published at least two weeks ahead, so employees can arrange childcare, travel and second jobs around it. Check the employment contract and any collective agreement as well, because either can set a notice period for shifts and for changes to them. Changes after publication are easier to accept when they go into the schedule itself rather than a group chat.

Shifts in the UK normally have to be 11 hours apart, not 8: an adult worker is entitled to 11 consecutive hours of rest in each 24-hour period under regulation 10 of the Working Time Regulations 1998. Workers under 18 are entitled to 12 hours. A shift worker who changes shift can miss the daily rest under regulation 22, but the employer must then give equivalent compensatory rest wherever possible. A late shift followed by an early one is the usual way to break the rule, a pattern known as a clopening.

An adult worker has no statutory right to a break on a 4-hour shift in the UK. The right to an uninterrupted rest break of at least 20 minutes starts when daily working time is more than six hours (regulation 12 of the Working Time Regulations 1998). Workers under 18 are entitled to 30 minutes once they work more than four and a half hours. A contract can give more than the law, and many do.

1st, 2nd and 3rd shift are the American names for the three 8-hour shifts of a business that runs around the clock. First shift is the day shift, roughly 07:00-15:00, second shift runs from the afternoon into the evening, and third shift covers the night. In the UK the same three are usually called earlies, lates and nights. Typical hours are under first shift hours.

The healthiest shift work schedule, according to the Health and Safety Executive's guidance HSG256, rotates forwards from early to late to night, either every 2-3 days or every 3-4 weeks. It keeps shifts to 12 hours at most and night shifts to 8 where the work is demanding, limits long or night shifts to 2-3 in a row, and leaves regular free weekends. Permanent night work is the arrangement HSE advises employers to avoid.

Covering one post 24/7 takes 168 hours a week, which at an average of 42 hours per person means four crews on 12-hour shifts. Holiday, sickness and training come on top, so most 24/7 sites plan for more than four people per post. How the four crews rotate is under 24-hour shift schedule.
