4/10 Work Schedule

A 4/10 schedule packs 40 hours into four ten-hour days. How to set it up, what it does to breaks and overtime, and a template to start from.

In this article we take a closer look at the 4/10 work schedule revolution, its implications, and how it can optimise both business operations and employee satisfaction.

What is a 4/10 work schedule?

A 4/10 is a compressed workweek: four 10-hour days to reach roughly 40 hours, not a 32-hour “four-day week.” See our guide to shift patterns for how it compares with other set-ups.

  • 4×10 compressed hours (40h/4 days): Same weekly hours, fewer commutes.

  • Four-day, 32-hour week: Fewer hours and potentially different pay/coverage implications.

Managers often mix these up in policy and payroll. Use the right term in contracts and internal guidance. (See CIPD/Acas terminology on compressed hours and flexible working.)

Where confusion causes risk:

  • Performance targets built for 5×8 can misfit a 4×10 unless you reset anchor hours and SLAs.

  • Holiday and overtime rules hinge on hours and jurisdiction, not the marketing label.

A quick, side-by-side so you use the right term in policies, payroll, and rota planning:

Dimension

4×10 compressed workweek

32-hour four-day week

Core idea

Same 40 hours, spread over four 10-hour days.

Reduced hours (typically 32) over four ~8-hour days.

Weekly hours & pay

~40 hours; pay unchanged.

~32 hours; pay may be unchanged (100-80-100 trials) or pro-rated: state this in contracts.

Coverage & service

Fewer handovers; good for project, construction, field work. Risk of late-day fatigue and childcare clashes.

Wider wellbeing/retention benefits; may require extra headcount or staggered coverage to meet peak demand.

Fatigue risk

Higher per day (especially nights/repetitive tasks). Build breaks, rotation limits, recovery time.

Lower per day due to shorter shifts; weekly fatigue generally reduced.

Best for

Teams wanting fewer mobilisations and longer focus blocks without cutting hours or pay.

Organisations targeting wellbeing/retention and employer brand, with stable demand or automation to maintain service.

Common pitfalls

Skipping AWS in CA; under-estimating late-day error rates; break rules not enforced in timekeeping.

Under-resourcing peak windows; unclear pay policy (same pay vs pro-rated); misaligned KPIs.

Payroll/time tracking setup

Weekly and daily OT rules (by jurisdiction), paid/unpaid breaks, max hours per day.

Shorter contracted hours, revised thresholds for OT, pro-rated allowances/benefits if applicable.

Documentation to keep

AWS election records (CA), updated rota policy, risk assessment on fatigue, employee consent.

Flexible working decisions per Acas Code, updated contracts, holiday-pay methodology for irregular/part-year staff.

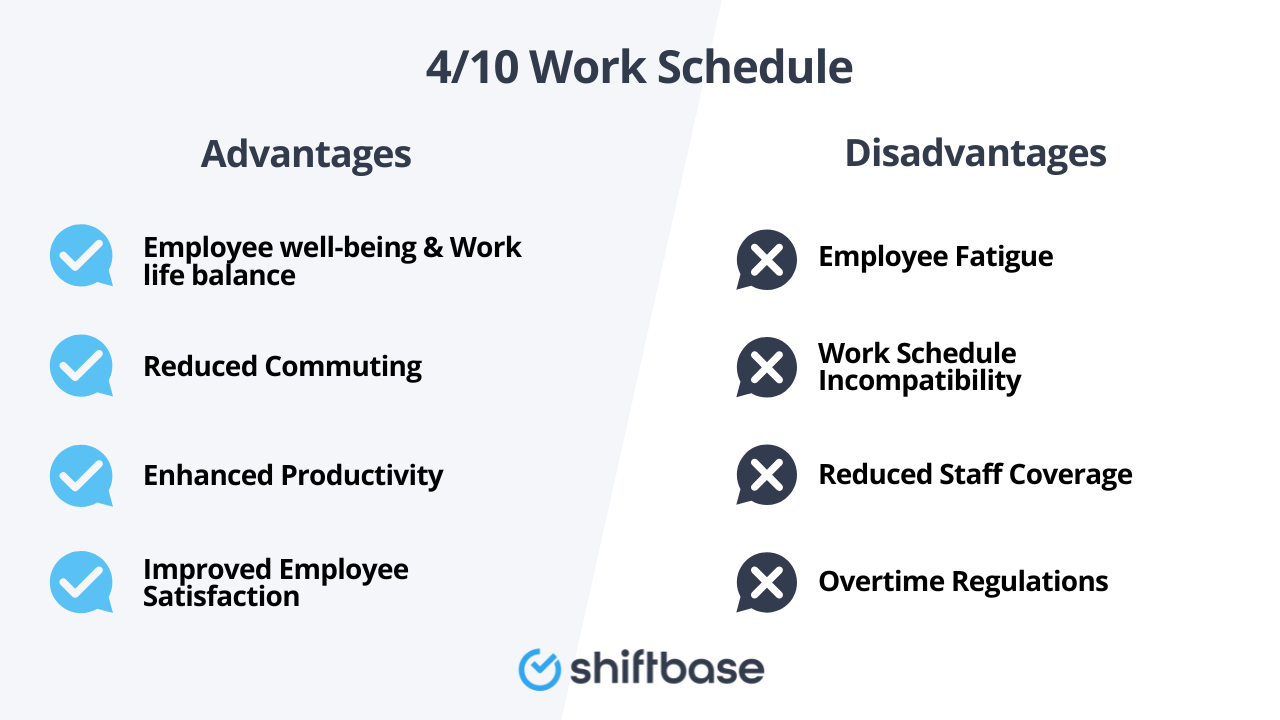

Pros and trade-offs that actually matter

Moving to 4×10 can cut handovers and commutes, but longer days raise fatigue and coverage challenges.

Tangible upsides managers report

  • Fewer mobilisations in construction/field teams; longer focus blocks for project work.

  • Reduced travel/parking costs and simpler rota coverage on stable demand days.

Real-world trade-offs to plan for

  • Fatigue risk rises with longer shifts, especially at night or in repetitive, machine-paced work. Build breaks and limits into the pattern.

  • Childcare and peak customer windows can clash with 10-hour days; staggered “off” days help maintain service.

Fatigue safeguards you should adopt (quick checklist)

  • Minimum 11 hours rest between shifts where practicable; avoid >4 consecutive long days.

  • Use forward rotation (earlier → later) and protect at least one full weekend in any 14-day block.

  • Bake paid rest breaks into the 10-hour template; add an extra micro-break for safety-critical tasks.

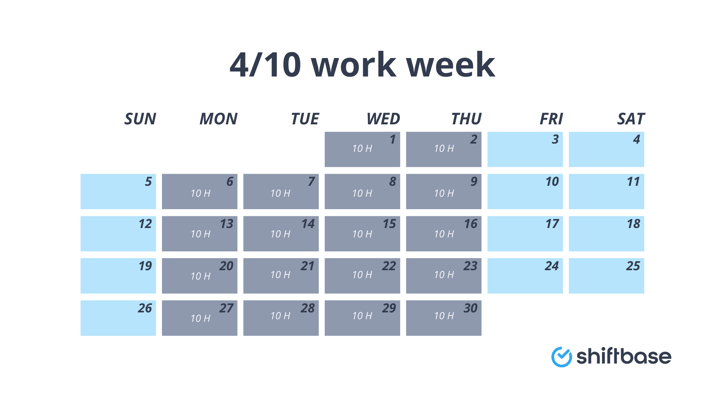

When a 4/10 makes sense (by sector)

Adopt 4×10 where long blocks boost productivity and service, and avoid it where risk or demand spikes make 10-hour shifts inefficient.

Sector fit matrix (quick view):

Sector / context

Usually a good fit

Proceed with caution

Why

Construction & field service

✔

Fewer mobilisations; site setup once per day; predictable tasks.

Manufacturing (day shift)

✔

Nights / heavy monotony

Longer blocks increase throughput; fatigue risk rises on nights: use extra controls.

Contact centres / retail

✔

Demand peaks may require 8-hour coverage windows and split patterns.

Safety-critical (healthcare, transport)

✔

Evidence links longer shifts to fatigue; consider 8–9h or forward-rotating patterns.

Compliance snapshot

Overtime and flexible-working rules differ: align your 4×10 with the jurisdiction, not just company policy.

US: federal baseline

Key state overlays you must check

  • California: Daily overtime after 8 hours unless you adopt a formal Alternative Workweek Schedule (AWS) via a secret-ballot election and file results with the state. Without AWS, a 10-hour day triggers 2 hours of daily OT.

  • Colorado (COMPS): Overtime after 12 hours in a day (or 40/week), so a 13-hour day pays 1 hour OT even if weekly hours ≤40.

UK: flexible working & holiday pay

Pilot a 4/10 without breaking service levels

A tight pilot proves whether 10-hour days help your customers and your team, before you roll out.

The 4-step pilot plan

  1. Define demand & guardrails
    Map peak hours, must-cover roles, and SLAs. Set hard limits: max daily hours, minimum rest, break rules.
    Why: keeps service and safety ahead of enthusiasm.

  2. Design staggered coverage
    Create two or three off-day patterns (e.g., Mon–Thu, Tue–Fri, Wed–Sat) to spread capacity. Add a small floating team for peaks and absence.
    Why: avoids “ghost Fridays” where everyone is off together.

  3. Run a time-boxed test (6–8 weeks)
    Lock the rota, brief teams, and collect baseline vs pilot data weekly.
    Why: enough time to see fatigue, cost, and customer effects.

  4. Review, tune, or roll back
    Compare KPIs, adjust breaks/rotation, or revert to 5×8 if targets slip.
    Why: protects service levels and trust.

Pilot KPI tracker (use these to judge success)

KPI

Target in pilot

How to measure

What “bad” looks like

Service level / response time

Hold or improve baseline

Ticket/phone logs, SLA reports

>5% slip vs baseline

Overtime cost per FTE

Flat or ↓ after week 2

Payroll export vs scheduled hours

Sustained ↑ week-on-week

Error/incident rate

Flat or ↓

Quality audits, incident reports

↑ trend in week 3–4

Absence & turnover signals

Flat or ↓

HRIS, leaver reasons

Spike in fatigue-related notes

Employee feedback (fatigue)

≥70% “manageable”

Short pulse survey

<60% or rising complaints

Safety & fatigue controls (build into the rota)

  • Keep forward rotation (earlier → later) and protect at least one full weekend off every 14 days.

  • Enforce paid rest breaks inside the 10-hour day; add micro-breaks for safety-critical work.

  • Maintain minimum 11 hours rest between shifts where practicable; cap consecutive long days (e.g., 3–4 max).

⚠️ Long shifts increase fatigue risk; controls reduce incidents and errors

How Shiftbase helps teams run a clean 4/10

Set up your 4×10 once and keep it compliant. With employee scheduling you can create rota templates for 10-hour shifts, stagger off-days to protect coverage, publish open shifts, and use conflict warnings to avoid overloads. Our time tracking enforces paid breaks, minimum rest, and daily/weekly overtime rules (useful where daily OT applies), while audit-ready timesheets make payroll reviews faster. Tie it together with absence management to handle holiday requests on compressed hours, prevent clashes, and keep entitlement accurate.

Try it free for 14 days: model your 4×10 against real demand, then roll it out with confidence: start your trial.

Frequently asked questions

Under federal FLSA, overtime starts after 40 hours in a workweek. Some states add daily rules (e.g., California, Colorado). Always check your state.

Yes. Compressed hours are a valid pattern under the Acas Code (2024). Follow the request process, assess business reasons, and record the decision.

Statutory entitlement stays at 5.6 weeks; a day of leave equals the length of a normal working day in your pattern (e.g., 10 hours on a 4×10). For irregular/part-year workers, 2024 reforms explain accrual and rolled-up holiday pay.
